Flow Metrics & Analytics

Monte Carlo: Delivery Date

What it answers

When will this work be finished?

See when a set of work is likely to be completed and understand the risk of missing a deadline.

Example

How to read it

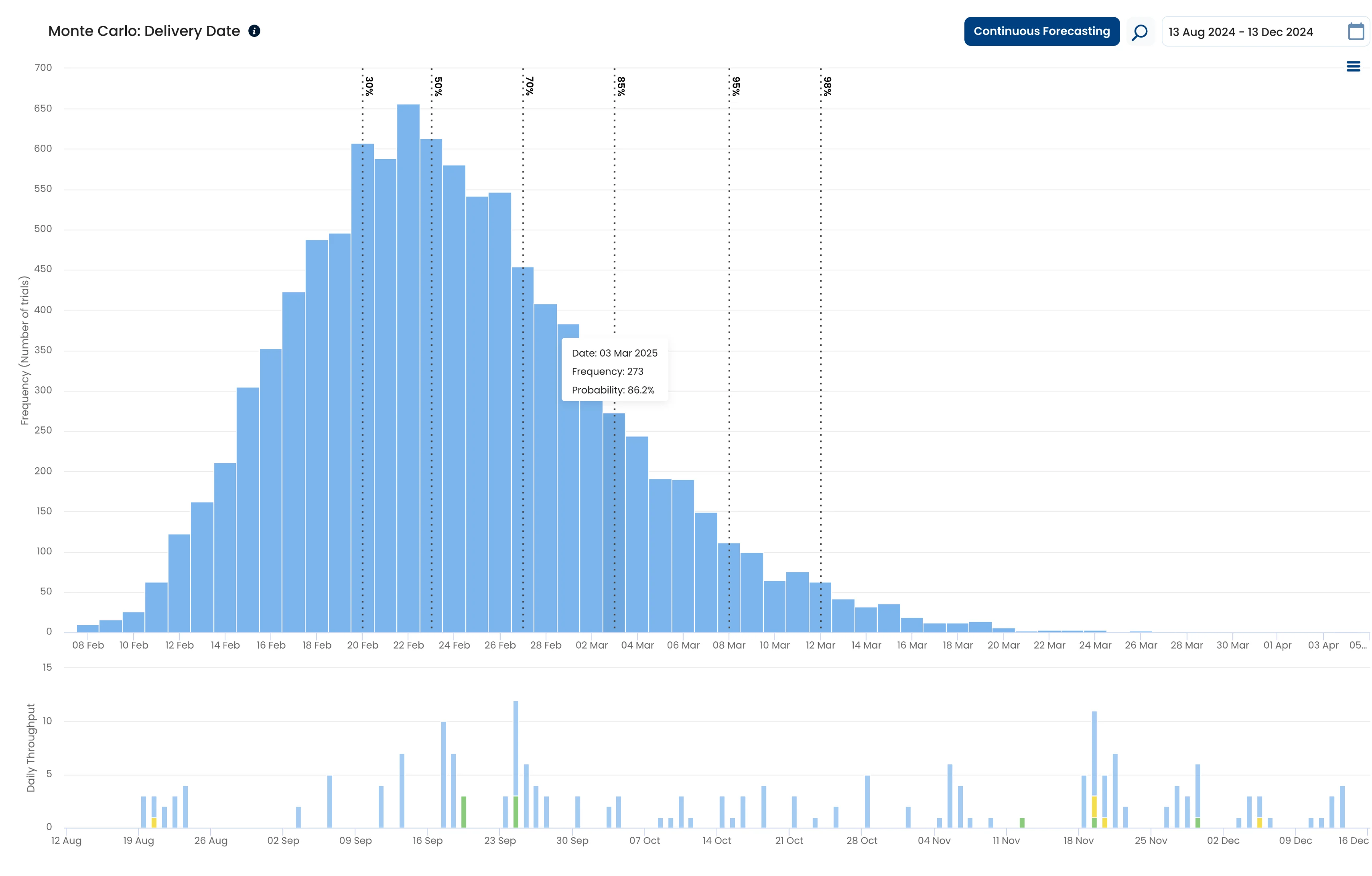

Monte Carlo: Delivery Date in Nave: a histogram of possible delivery dates with percentile lines, a probability tooltip, and the Daily Throughput chart
  1. Possible delivery date

    Each bar represents one possible delivery date with an assigned probability. The distribution shows the likelihood of finishing the work on different dates.

  2. Percentile line

    A vertical dotted line shows the probability of finishing all the work by a certain date. For example, the 85% line marks the delivery date associated with 85% confidence.

  3. Date, frequency, and probability

    The tooltip identifies a possible delivery date, its frequency, and its assigned probability. The probability shows the likelihood of finishing the work on that date.

  4. Daily Throughput

    The simulation uses past throughput data to generate possible scenarios and predict likely delivery dates.

See the Monte Carlo: Delivery Date in action

Understand the probability distribution chart

Monte Carlo: Delivery Date uses past throughput data to generate thousands of possible outcomes. The probability distribution graph shows possible delivery dates and the probability assigned to each date, rather than a single fixed deadline.

Moving further right on the curve gives you more certainty, but also a later delivery date. Compare probability levels such as 70% and 85% to balance speed and confidence.

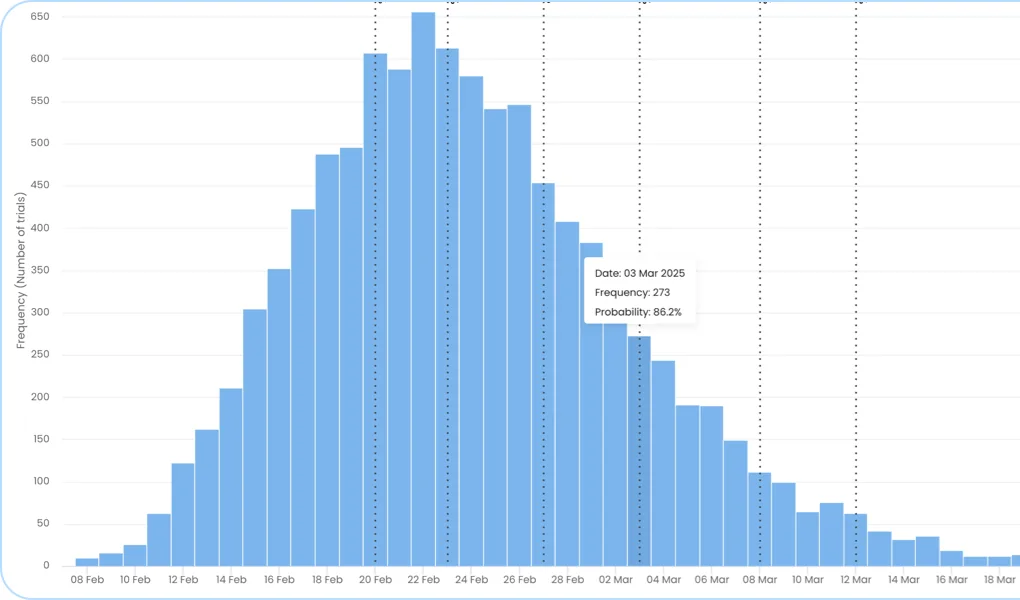

The Monte Carlo: Delivery Date histogram: possible delivery dates and their probability

Use percentiles to set reliable delivery dates

The vertical dotted lines are percentiles. They show the probability of finishing all the work by a certain date, including 30%, 50%, 70%, 85%, and 95%. Use them to compare confidence levels and decide how much risk to take when committing to a delivery date.

For easy work, a stable delivery workflow, and no expected obstacles, use a lower percentile such as 70%. For complex or unfamiliar work with many unknowns, use a higher percentile such as 95% or 98%.

Percentile lines on the Monte Carlo: Delivery Date chart, from 30% to 98%

Define your simulation scope

Use the simulation controls to set the start date, number of items to complete, and number of trials. The simulation uses past throughput data to generate possible scenarios and predict the most likely delivery dates.

Save the simulation’s start and end dates and item count in a dashboard view, then use that configuration in a wallboard. Small deviations can occur because the simulation produces different outcomes.

Include new and in-progress tasks in the total count. The simulation predicts how many tasks will be finished by a given date, not which specific tasks will be completed.

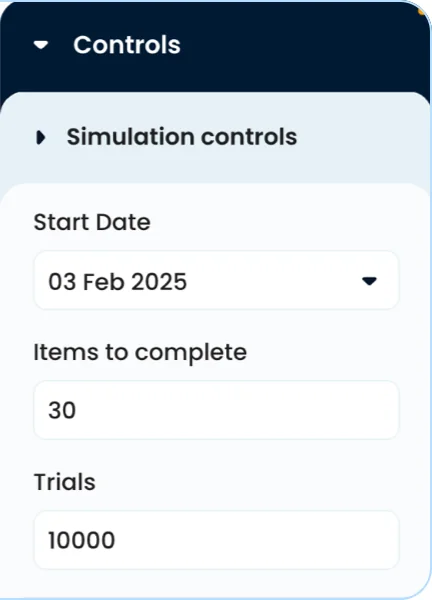

Simulation controls: Start Date, Items to complete and Trials

Scale your throughput to account for performance changes

The scale factor adjusts the forecast for expected changes in team performance. Scale throughput down for an expected slowdown, such as holidays or resource constraints, or scale it up for an expected increase in delivery speed, such as after onboarding new team members.

The default scale is 0, so the simulation uses past performance without adjustments.

Use the scale factor only when you expect throughput to change and have no historical data for similar conditions. If past data already reflects those conditions, rely on it instead.

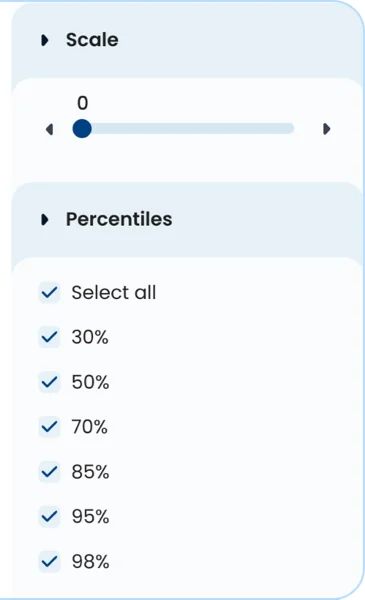

The Scale control, defaulted to 0, above the Percentiles list

You can export the filtered data shown in this chart as a CSV.

What to look for

The peak and tails

Identify the peak as the most likely delivery date, then compare it with the optimistic and conservative outcomes in the tails.

A commitment near the 50th percentile

Investigate whether a delivery date at the 50th percentile provides enough confidence, since that confidence level is comparable to flipping a coin.

Expected changes in throughput

Check for expected slowdowns or increases in delivery speed, and whether past data already reflects similar conditions.

Monte Carlo Simulation Explained

What decisions it helps you make

  • Compare probability levels, such as 70% and 85%, to balance delivery speed and confidence.
  • Choose how much risk to take when committing to a delivery date.
  • Use a lower percentile, such as 70%, when the work is easy, the delivery workflow is stable, and no obstacles are expected.
  • Use a higher percentile, such as 95% or 98%, when the work is complex, unfamiliar, or has many unknowns.
  • Include both new and in-progress tasks when setting the total number of items.
  • Use the scale factor when throughput is expected to change and historical data does not reflect similar conditions.
